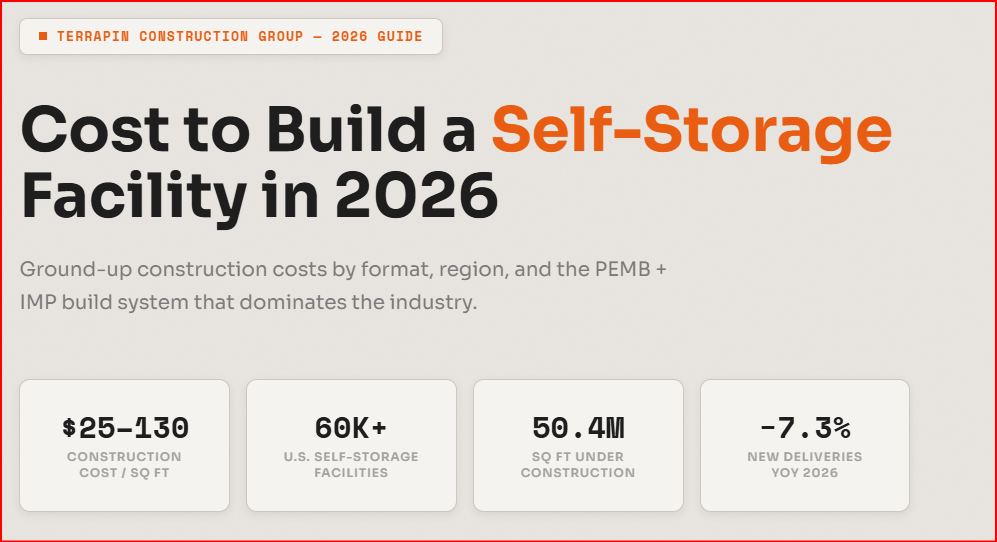

Average Cost to Build a Self-Storage Facility in the USA - 2026

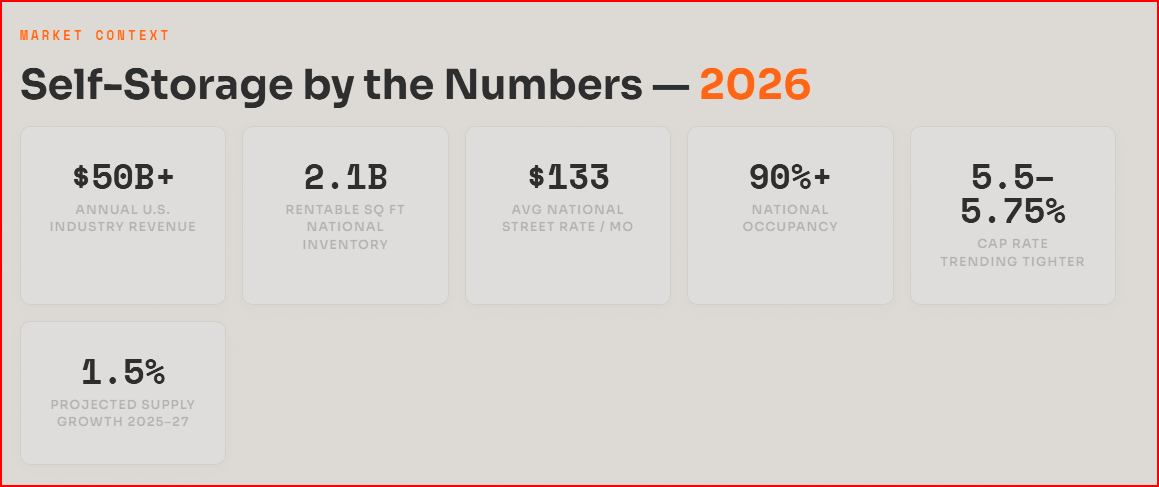

What changed in self-storage construction this month
Three forces moved the per-square-foot benchmarks since the April release. National operators kept slowing new development, but private regional developers and 1031-driven owners filled the gap. The cost story is no longer "is it cheap to build?" It is now "can the deal pencil at stabilized cap rates?"
The April update from Yardi Matrix's National Self-Storage Report showed that under-construction inventory is now 3.0 percent of existing stock, the lowest reading since 2017, while street rates softened in 60 of the top 100 metros. That divergence of falling supply and softening rates has compressed the pro-forma yield-on-cost target from 8.5 percent to about 7.5 percent in core markets, which means construction cost overruns punish underwriting harder than they did 24 months ago.
On the cost side, three line items moved up in May 2026. Imported steel framing components are 4 to 7 percent higher after the latest tariff round. Sprinkler labor in the Sun Belt is up 6 percent on demand from data center construction pulling MEP trades. PV-ready electrical service upgrades, increasingly required by IECC-adopting jurisdictions, added $0.40 to $0.90 per gross square foot to multi-story projects. AGC's Construction Inflation Alert for Q2 2026 confirms the steel and electrical pressure.
Two line items moved down. Long-span insulated metal panels priced through volume installer relationships are flat to slightly cheaper as domestic IMP capacity expanded. Roll-up door lead times have normalized to 4 to 6 weeks after the 2025 backlog. Drywall, polyaspartic flooring, and security electronics held flat.
The takeaway for May 2026: the cheapest path to first-stabilized-month rent is still an insulated metal panel envelope on a structural steel frame, delivered design-build rather than design-bid-build. The compounding cost savings come from compressed schedule, reduced change orders, and earlier rent commencement, not from beating up a single line item.
Self-storage construction cost per square foot (May 2026)
National per-gross-square-foot ranges from TCG's preconstruction database cross-checked against RSMeans 2026 and recent CBRE Self-Storage Figures. Hard costs only, excluding land, soft costs, and FF&E. See the soft-cost section below for total-project math.

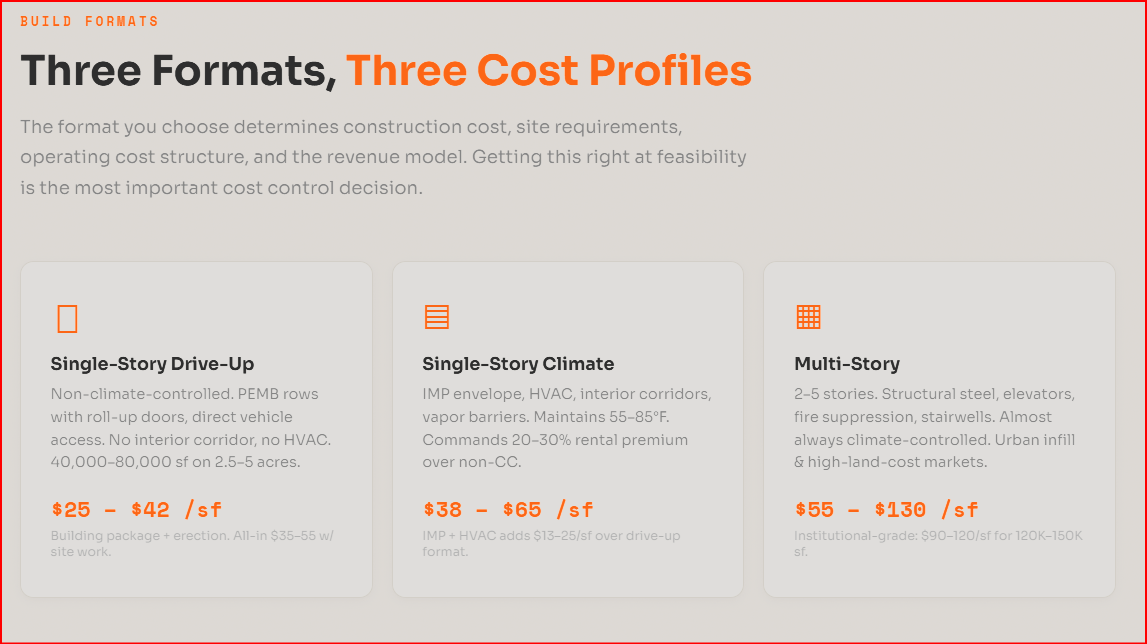

Drive-up, ambient temperature
PEMB or block-and-steel construction, roll-up doors, asphalt drives, no climate control. The lowest cost-per-foot product. Net rentable efficiency 80 to 88 percent.
Conditioned interior, drive-up rare
IMP or insulated wall assembly, conditioned space, vapor retarder, robust HVAC, polyaspartic floor coating common. Higher street rates per foot offset the build premium.
Two to four floors, urban infill
Structural steel or composite, elevators, sprinklers per NFPA 13, full envelope, security, ADA. The dominant urban product type.
Roof structure, open sides
PEMB roof, gravel or paved drives, no walls or partial walls. Low capex, large land footprint. Strong cap rate in lake and coastal markets.
Walled, ambient or conditioned
PEMB or IMP envelope, oversized roll-ups, taller clear heights, often with wash bays. Climate-controlled indoor boat is a separate tier.
Premium yacht and RV product
High-clear-height conditioned space, oversized doors, polished concrete or polyaspartic, dehumidification. Lake markets in TX, FL, AZ, NV, CA.
Retail, warehouse, office to storage
Existing shell with adequate clear height, column spacing, and floor loading. Demolition, partition framing, MEP rework, sprinkler upgrade. Often the fastest path to revenue.
Tightly conditioned premium
Tighter temperature and humidity tolerances, redundant HVAC, generator backup, fire suppression upgraded for high-value contents. Niche but high-margin.

Single-story climate-controlled cost by region
National averages obscure the 40 percent regional spread. The bars below show TCG's May 2026 benchmarks for single-story climate-controlled construction across nine major regions, as a percentage of the national high end.
The spread reflects labor cost differentials, prevailing wage exposure, code stringency (especially seismic in CA and energy code in NY and MA), permit timelines, and impact fee schedules. Permit timeline data by state tracks closely with the regional cost premium. Long-lead jurisdictions bake in carrying cost, change-order risk, and escalation.

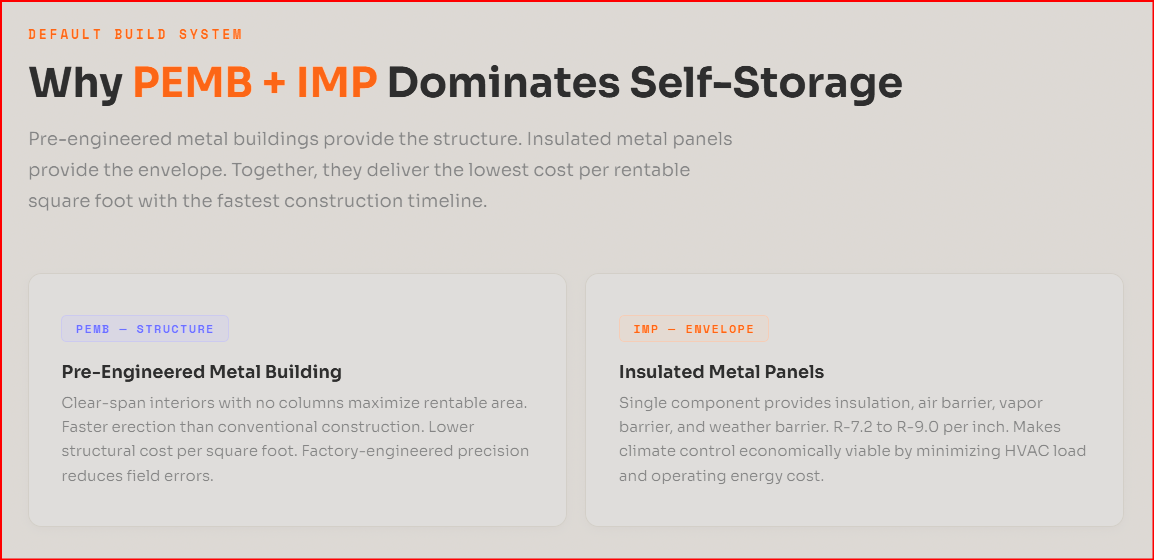

PEMB vs. IMP-on-steel vs. tilt-up vs. CMU for self-storage

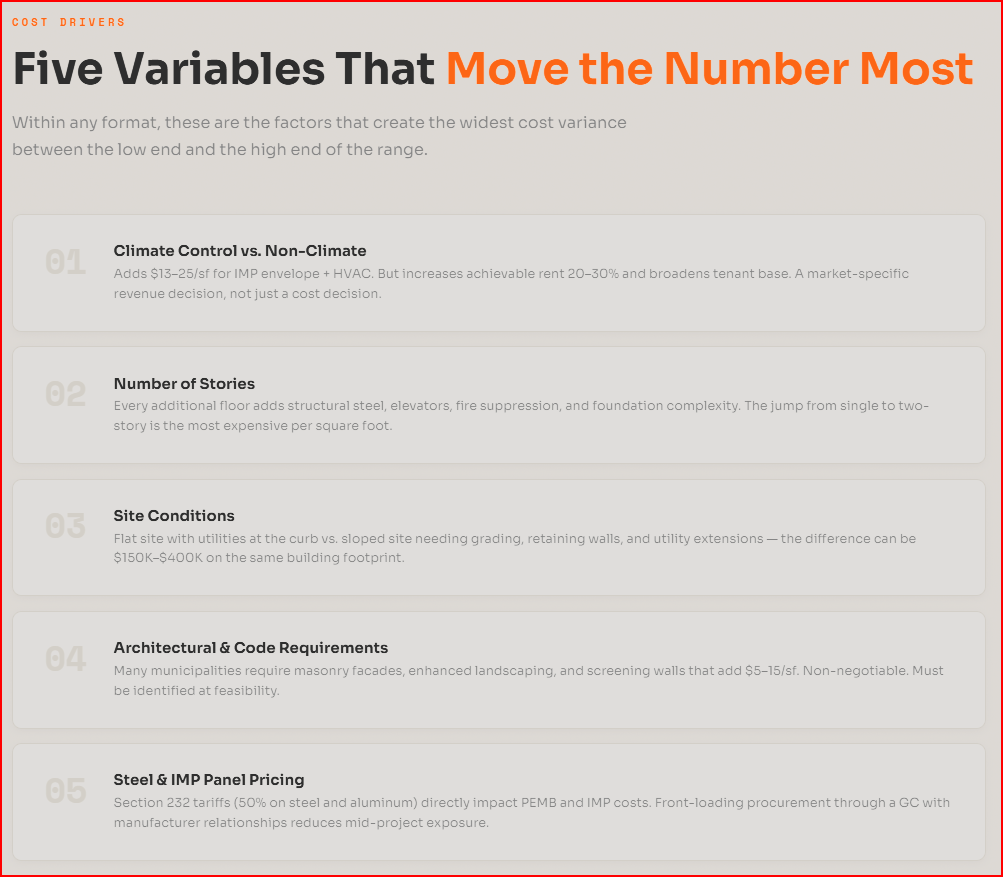

The structural and envelope decision drives 35 to 45 percent of total hard cost. Choose for total cost of ownership, not just lowest bid.
Pre-Engineered Metal Building (PEMB). The default for single-story conventional drive-up self-storage. Lowest cost per square foot, typically $22 to $38 per SF for shell, with finished assembly $55 to $80. Fast erection, predictable engineering, minimal field labor. Limitations show up at climate control: PEMB envelopes leak air at panel-to-frame interfaces unless tightened with custom flashing.
Insulated Metal Panel envelope on structural steel. The right choice for climate-controlled and multi-story. IMP installation delivers the air barrier, vapor retarder, and continuous insulation in one trade and one product, dropping HVAC equipment size and lifecycle energy cost. For multi-story projects, IMP shaves 4 to 8 percent off total project cost vs. tilt-up by speeding the dry-in date and reducing crane time. 2026 IMP install pricing ranges $14 to $45 per SF depending on R-value and panel finish.
Tilt-up concrete. Common in Texas and the Southeast for multi-story self-storage. Cost-competitive at scale (typically $14 to $22 per SF for the wall system), durable, naturally fire-resistive, and dimensionally accurate. Penalty: slow envelope close-in compared to IMP, intensive crane scheduling, and harder to value-engineer once panels are cast. The IMP-versus-tilt-up cost comparison from cold storage applies almost identically to multi-story self-storage.
Concrete masonry unit (CMU). Still appears on infill urban projects where fire ratings or zoning push masonry. Higher labor cost, slower schedule, lower thermal performance unless paired with continuous exterior insulation. Defensible in coastal hurricane markets and when local code pushes Type II construction.
The TCG decision rule
For a single-story conventional drive-up product on suburban land, choose PEMB. For a single-story climate-controlled product, choose an IMP envelope on a PEMB or steel frame. For a multi-story climate-controlled product on infill or urban land, choose an IMP envelope on structural steel and deliver it design-build to compress schedule by 15 to 25 percent versus design-bid-build.
Get a defensible self-storage budget in under five minutes
Run TCG's AI-powered estimator for any project type. Upload plans for instant IMP pricing. Or book a 30-minute preconstruction call.
From hard cost to all-in project cost
Self-storage hard cost is the headline number, but the all-in project cost is what gets underwritten. Soft costs and FF&E typically add 25 to 40 percent to hard cost on ground-up projects.
Soft costs run 15 to 22 percent of hard cost on most self-storage developments. Architectural and engineering fees account for 5 to 8 percent, lower than hospitality or healthcare because self-storage design is highly repeatable and prototypes accelerate documentation. Permits, plan review, and impact fees absorb 2 to 5 percent depending on jurisdiction. Financing costs (origination, appraisal, environmental, title) consume 3 to 6 percent. Insurance and bonding are 1 to 2 percent. Construction loan draw schedules dictate when those costs hit the cash flow.
FF&E and security technology are the under-budgeted line items. Roll-up doors, hallway access systems, kiosk hardware, security cameras, gates, fencing, signage, and the management software stack (typically Storable, Storedge, or sitelink) come to 4 to 8 percent of hard cost on a typical multi-story climate-controlled project. GC-led equipment procurement compresses lead time and unlocks volume pricing on doors and security packages. TCG's manufacturer relationships routinely save 6 to 12 percent on this scope.
Land cost varies wildly by market. The underwriting heuristic in 2026 is land-to-total-project-cost of 12 to 18 percent in tertiary markets, 18 to 28 percent in core suburban markets, and 30 to 45 percent in dense urban infill where land is the binding constraint. SBA 504 financing remains the dominant capital stack for owner-operators under $15M total project cost.
Total project cost rule of thumb (May 2026)
For a 60,000 GSF single-story climate-controlled facility in a typical Sun Belt suburban market: hard cost $5.4M to $7.2M, soft cost $0.9M to $1.4M, FF&E and security $0.4M to $0.7M, land $1.2M to $2.4M. All-in project cost $7.9M to $11.7M, or $132 to $195 per gross square foot delivered. Net rentable efficiency 82 percent yields $161 to $238 per net rentable square foot.
When conversion beats ground-up
Big-box retail vacancy, obsolete office, and low-clear warehouse have driven the largest pipeline of self-storage conversion in 2026. The math works when the existing shell delivers four conditions.
The four conditions: clear height of 14 feet or greater for single-story conditioned conversion or 12 feet for ambient; column spacing of 30 feet by 30 feet or wider to support efficient unit layouts; floor loading of 100 PSF or greater to support multi-story unit stacks where applicable; and existing fire suppression rated for ordinary-hazard occupancy or upgradable without slab demolition. Miss any of those and the conversion premium evaporates.
Conversion hard cost runs $35 to $70 per gross square foot in May 2026, roughly 40 to 60 percent of ground-up. The savings come from existing structural shell, foundation, slab, and most of the envelope. Costs that do not shrink: interior partition framing, MEP rework, sprinkler retrofit, security and access control, and code-mandated ADA and IECC upgrades. Material lead times on doors and HVAC are still the schedule-critical items even in conversion.
The biggest conversion win in 2026: vacant former Sears, Toys R Us, Bed Bath & Beyond, and large-format Office Depot footprints in second-tier suburbs where land cost would be prohibitive for a ground-up climate-controlled product. Adaptive reuse also pulls forward revenue commencement by 6 to 10 months versus ground-up, which at a 7.5 percent yield-on-cost target is worth $0.45M to $0.75M in NPV on a typical $8M project.
The five planning mistakes that blow self-storage budgets
1. Underestimating net rentable efficiency. Pro formas built on 85 percent efficiency assumptions for a multi-story climate-controlled product will miss revenue by 12 to 18 percent. Multi-story typically delivers 65 to 75 percent net rentable. Run the layout before you lock the loan amount. Architectural fees for a real space-plan study are trivial compared to the underwriting risk.
2. Skipping the GC until after design. Nine of ten self-storage projects are designed over budget because the GC is not involved until after design closes. Constructibility, structural system selection, and envelope choice all change the budget by 8 to 15 percent and they are locked by the architectural CD set. Bring the GC into preconstruction at schematic design. Design-build is the cleanest version of this discipline.
3. Cheap envelope on a climate-controlled facility. Saving $4 per SF on the envelope to "value engineer" the project costs $1.20 per SF per year in HVAC operating cost on conditioned space. Over a 25-year hold, that is a 7 to 9 times payback the wrong direction. Specify continuous insulation and an air-tight assembly. FM-rated insulated metal panels often pay back inside year three on insurance premium reduction alone.
4. Under-sizing electrical service. Multi-story climate-controlled with EV-ready parking, security, kiosks, and 24/7 access requires 800A to 1,200A service. Cheaper 600A service designs require expensive utility upgrades during operations. Commercial electrical cost per square foot has increased fastest in 2026. Get the service sizing right at design.
5. Choosing the lowest bid on roll-up doors and security. Doors and security electronics are the two systems your customers touch every day. Door failures and access-control glitches drive vacancy faster than any other operational issue. Specify Trac-Rite, DBCI, or Janus doors with 5+ year warranties and Storable or Janus Noke or PTI access. The $80,000 to $140,000 you save on a cheap package costs $200,000+ in early-life service calls and vacate rates.
Stabilized economics: yield-on-cost, cap rate, and the deal that pencils
Construction cost only matters in the context of what the building rents for and what it sells for. The May 2026 numbers narrow the deal that works.
Stabilized cap rates per the Marcus & Millichap Self-Storage Investment Forecast are running 5.75 to 6.50 percent for core market climate-controlled and 6.50 to 7.50 percent for tertiary market drive-up. Yield-on-cost, the test for whether new construction makes sense, needs to clear 150 to 200 basis points above stabilized cap rate to justify development risk. That puts the YOC target at roughly 7.50 to 9.00 percent depending on market.
For a $9.5M all-in project (60,000 GSF single-story climate-controlled, 49,200 net rentable SF) with stabilized rents of $18 per net rentable SF and 92 percent occupancy, gross potential income is $885,600. After 8 percent vacancy and concessions and 32 percent operating expenses, NOI is approximately $554,000, a 5.83 percent YOC. That is below the threshold and explains why new development pulled back. The deals that pencil in May 2026 either have lower land basis (under-market acquisition or owner-contributed land), conversion math (40 to 60 percent of ground-up cost), or premium product (climate-controlled in a supply-constrained submarket clearing $24+ per net rentable SF).
The cost discipline that flips a marginal deal to financeable in 2026: 8 to 12 percent off hard cost through design-build delivery and direct manufacturer procurement; 6 to 10 months earlier rent commencement versus design-bid-build; FF&E and security packages priced through GC volume relationships; and tight envelope spec to drop opex by $0.40 to $0.80 per square foot per year.
Self-storage construction cost FAQ
In May 2026, single-story conventional self-storage costs $55 to $85 per gross square foot, single-story climate-controlled costs $80 to $120 per GSF, and multi-story climate-controlled costs $105 to $170 per GSF before land, soft costs, and FF&E. Add 25 to 40 percent for total project cost. Coastal California, the Northeast, and Pacific Northwest run 15 to 35 percent above national averages.
Multi-story climate-controlled self-storage costs roughly 50 to 100 percent more per gross square foot than single-story conventional. The premium pays for elevators, structural framing capable of upper-level dead loads, NFPA 13 sprinklers, MEP distribution, ADA-compliant circulation, and a tighter envelope. Multi-story also drops net rentable efficiency to 65 to 75 percent versus 80 to 88 percent for single-story, so per-net-rentable-square-foot cost is even higher.
Climate control adds approximately $20 to $40 per gross square foot to single-story self-storage. The premium covers HVAC equipment and ducted distribution, vapor retarder, insulated metal panels or fiberglass-batt-plus-continuous-insulation wall assembly, upgraded electrical service, and dehumidification in humid markets. The street rate premium typically runs 30 to 55 percent, which is why climate-controlled product dominates new construction in the Sun Belt.
Soft costs run 15 to 22 percent of hard cost for self-storage. Architecture and engineering account for 5 to 8 percent, permits and impact fees 2 to 5 percent, financing and legal 3 to 6 percent, insurance and bonds 1 to 2 percent, and FF&E plus security 4 to 8 percent. Land is tracked separately and varies from 12 to 45 percent of total project cost depending on market.
A single-story conventional facility takes 8 to 12 months from groundbreaking to certificate of occupancy. Multi-story climate-controlled facilities take 12 to 18 months. Permitting often adds 4 to 9 months upstream depending on jurisdiction. Design-build delivery typically compresses both phases by 15 to 25 percent versus design-bid-build.
Adaptive reuse conversion typically costs $35 to $70 per gross square foot, about 40 to 60 percent of ground-up, when the existing structure has 14+ ft clear height, 30 ft by 30 ft column spacing, 100 PSF floor loading, and upgradable fire suppression. Conversions of vacant big-box retail, obsolete office, and low-clear warehouse are the dominant cost-advantage path in 2026 and pull rent commencement forward by 6 to 10 months.
Pre-engineered metal buildings deliver the lowest cost per square foot for single-story conventional. For climate-controlled and multi-story, an insulated metal panel envelope on a structural steel frame outperforms PEMB and tilt-up concrete on a total-cost-of-ownership basis. Better envelope tightness, faster dry-in, lower lifetime HVAC load, and fewer change orders.
Covered RV and boat storage costs $25 to $55 per GSF, fully enclosed RV and boat costs $65 to $95 per GSF, and indoor climate-controlled boat runs $90 to $140 per GSF. Land coverage is the binding constraint. Covered RV requires 2 to 3 times the site area of comparable revenue from traditional storage, so the land math has to work before the construction math matters.
